One of Europe’s largest infrastructure projects is taking shape in the south of Frankfurt Airport: the construction of Terminal 3. After it has been completed, it will have capacity for up to 19 million passengers a year. They will take off and land at three piers, enjoy a central marketplace, and relax in comfortable lounges.

5.6 kilometers

is the length of the new Sky Line route.

That's equivalent to 14 laps around an Olympic track.

Learn more about the construction project.

News from the Building Site

Main terminal building

The heart of Terminal 3 is taking shape

The marketplace, covering an area of 12,200 square meters, is a special highlight of the new Terminal 3. Here project head Christian Bierend explains the progress made so far and describes the challenges that still remain, especially for making the roof.

Learn more about the ongoing work to build the carcass of the main terminal building.
Piers H and J

52 tonnes on the move

The shell of piers H and J is as good as complete and work on the facades is beginning. Steel structures weighing 52 tonnes are being assembled on the roof of Pier J. Felix Birkner, project manager for Pier J, explains the challenges involved. Work is also progressing at Pier H. Project manager Sebastian Wolber explains the current state of construction.


Learn more about the shell construction of Piers H and J.

The Progress of Construction in Pictures

Time-lapse movie of the construction of the T3 main building

Rising skyward from a huge pit: work to build Terminal 3 is advancing, with the piers and main terminal building steadily gaining in height. Watch the progress made so far at the construction site in the south of the airport in a time-lapse video.

Learn more about the main terminal building.

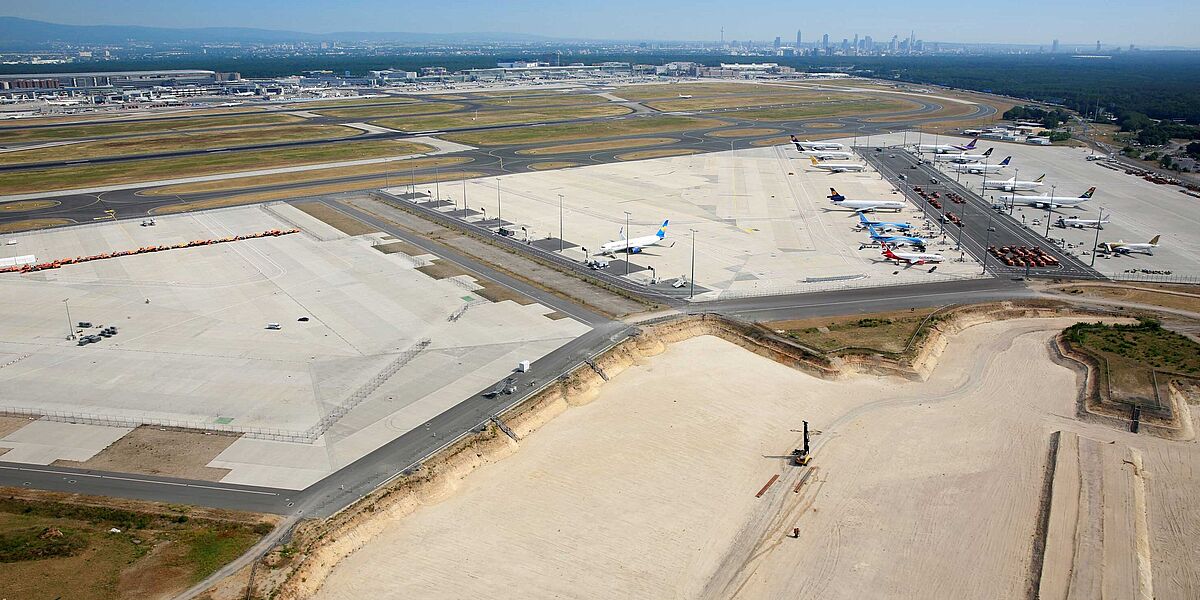

The construction project in June 2017

The Terminal 3 construction site during the dry excavation phase: the huge pit spanning 65,900 square meters and the ramps for the drive-by platform give an idea of the new terminal’s dimensions.

Learn more about the dry excavation phase.

The construction project in June 2018

The pit is deeper than the water table and therefore filled with groundwater. Industrial divers are the stars of a special underground engineering phase. The ramps for the drive-by platform have already been completed.

Learn more about the special underground engineering phase.

The construction project in September 2019

From above, the last water-filled basins at the Terminal 3 construction site are easy to spot. The advancing work on the drive-by platform and Piers G and H is also plain to see.

Learn more about the ramps.

The construction project in February 2020

Visible progress being made on the carcass: the first concrete structures are already standing, especially for Pier H and the main terminal building. The first V-shaped supports for the drive-by platform are also prominent.

Learn more about Piers H and J.

The construction project in April 2021

The terminal is growing in height. The outlines of the main building with its three piers are clearly visible. The apron control tower with its 69 meters towers above everything.

Learn more about the control tower.

A Glimpse of the Future

Peer interactively into the future and inspect Terminal 3 from all sides in 3D!

More News from the Building Site

Sky Line people mover

A major job for two cranes

Work on the new Sky Line people mover is progressing at multiple sites. Project heads Wolfgang Holzhausen and Stefan Passarge of the Max Bögl construction company explain the challenges for placing the 200-tonne concrete supports for the tracks. It’s impressive to watch them being delivered and lifted into place by two cranes working in tandem. Millimeter precision is required.

Learn more about construction of the new Sky Line route.
Road connections

Nights on the A5 motorway

It took several night shifts to enlarge the Zeppelinheim interchange, since the A5 motorway had to be temporarily closed to do the work. In this video, project head Axel Kirn explains how the roadblocks were implemented and what was done there at night under extreme time pressure.

Learn more about the road construction measures.
Pier G

Inner values

Many different professions are involved in building and equipping this pier, which will initially have a length of 400 meters. The work required to fill Pier G with life includes applying 160,000 cubic meters of surfacing materials on top of the loadbearing concrete layer and installing 20,000 meters of heating and cooling pipes as well as 9,500 meters of ventilation shafts. The base of the pier (the part closest to the main terminal building) will contain the baggage conveyor system with a total of 1,224 meters of tracks able to move at least 2,000 pieces of luggage per hour toward the planes or back to their owners.

Learn more about the inner workings of Pier G.
Road connections

Cars on eight levels

A new eight-level parking facility at Terminal 3 will have room to accommodate 8,500 cars and include specially equipped spaces for electric vehicles.

Learn more about the construction of the parking facility.

The Most Important Milestones in Our Interactive Timeline

July 8, 1936

A lively past

The expansion of Frankfurt Airport into an airship port with giant airship hangars began in the south of the airport in 1934. At its inauguration in 1936, everyone talked about this new “world airport”. But the demise of the Hindenburg, one of the largest airships ever built, in a highly publicized accident abruptly ended the zeppelin era in Frankfurt. From that time on, passenger aircraft with increasing passenger capacities replaced the airships. Almost all major European cities were now accessible from Frankfurt. The new Terminal 3 has been under construction in the south of the airport since October 2015.

Read all
October 1997 to June 2000

Dialog on expansion

Following talks between Fraport and the city of Frankfurt on the  expansion of the airport in the late 1990s, a comprehensive two-year mediation process was initiated. Besides Fraport, it involved representatives of the government of the state of Hesse, residents of nearby communities, citizens’ initiatives, employers’ associations, and trade unions. Over the course of two years, the participants agreed on the general conditions for expanding the airport. In June of 2000, the government of Hesse approved the project. Immediately afterward, the supervisory board of Fraport AG publicly announces its plan to expand the airport.

Read all
2001 to 2005

Architectural and implementation competition

No fewer than 46 architectural firms all over Europe submitted their ideas for the new terminal at Frankfurt Airport. Foster and Partners of London won the architectural competition on June 28, 2002 by convincing the eight-member jury with a modern, sustainable concept. In the subsequent competition to choose who would design the actual terminal, Frankfurt-based architect Christoph Mäckler won out against nine other architectural firms with his credo of “modern with a feel-good ambiance”. The three main parts of the building―the check-in hall, the airside areas after the security checkpoints, and the central marketplace―were conceived as modules that could be flexibly modified as required.

Read all Read more
December 18, 2007

Zoning plan approved by economics minister Alois Rhiel

The landmark decision to approve the zoning plan met the prerequisites for expanding the airport by building a new runway and a new terminal. It defined the construction projects and infrastructural measures that Fraport would implement. The resolution also covered the enlargement of the Zeppelinheim interchange on the A5 motorway and the construction of a new Sky Line people mover line to link Terminal 3 with Terminals 1 and 2.

Read all
2014

Permission received to build Terminal 3

The official approval for building Terminal 3 was a major milestone―the planning work was then able to really get going. In the first phase of the project, two piers with 24 adjacent aircraft parking positions were built. The permit also stipulated that the new Sky Line station there would be in a raised position alongside the terminal drive-by platform. The original plans had called for it to be on the first underground level of the terminal building.

Read all
October 2015

Groundbreaking ceremony

A very special day: after more than 15 years of intensive planning, permit applications, and tests, the official starting gun went off at Frankfurt Airport for Europe’s largest-ever privately funded infrastructure project. Four hundred Fraport employees and 200 invited politicians and business leaders were on hand for this momentous occasion.

Read all Read more
November 2015 to May 2016

Excavation of an area of 65,900 square meters

Right after the groundbreaking ceremony in October 2015, the first phase of construction got underway: dry excavation. A pit spanning 65,900 square meters was created in only six months. To accomplish this feat, excavators removed enough earth to fill an average of around 300 dump trucks a day. At the peak of activity, the volume amounted to 5,500 cubic meters per day.

Read all Read more
June 2016

Road construction

Terminal 3 must be easy to reach by car, taxi and bus. To ensure this, new access roads were built and the Zeppelinheim interchange on the A5 motorway was enlarged and extended. The first major related project was construction of the access and exit ramps for the elevated drive-by platform, which would be at the same height as the departures level of Terminal 3. First a total of 48 foundation piles 1.2 meters in diameter with lengths of up to 18 meters were driven into the ground. Their role was to stabilize the ground so the ramps would have a sturdy foundation. Then cages made of steel reinforcement bars (rebars), with a length of nine meters and weighing 4.5 tonnes, were lifted onto the piles, welded together, and filled with concrete. For the access ramp, molds were made of appropriately shaped formwork and then filled with concrete.

Read all Read more
Summer 2017

Start of the special below-ground engineering phase

In the second phase―special below-ground engineering―wet excavation deepened the pit further down to its final depth well below the water table. After specially trained divers had prepared the bottom, concrete was poured to create a solid foundation. To prevent more water from entering the pit from the sides, first it was sealed by retaining walls. After the poured concrete had cured to the required hardness, the water in the pit was pumped out, purified, and returned to the soil.

Read all Read more
March 2018

The new people mover

Fraport began building a new Sky Line people mover to make sure that everyone can get to and from Terminal 3 without hassles, including passengers changing planes at Frankfurt Airport and those who get to Terminal 1 by train. Besides the tracks, a large maintenance building and a new station are being constructed at Terminal 1, with all of the work being done in cramped conditions between other facilities without interrupting operations―a major engineering and logistical challenge. Work on the bored piles for the route began in July 2019.

Read all Read more
August 2018

Building permit for Pier G

The building inspectorate of the city of Frankfurt issued a permit for the construction of Pier G to begin earlier than originally planned. The new pier would shoulder part of the traffic handled by the existing Terminals 1 and 2.

It is a full-fledged, state-of-the-art aircraft and passenger handling facility with lean, straightforward processes. Once it begins operating, initially four to five million passengers per year will be able to travel via Pier G.

The contract was awarded to the general contractor at the end of 2018, and construction began in June 2019. The first phase of construction work for Pier G was largely complete before the end of 2021.

Read all Read more
January 2019

Start of shell construction for Piers H and J

Following the foundation work, the construction of Pier H with an integrated apron control tower began, marking the official start of the structural work for Terminal 3. Work on Pier J also kicked off in the first half of 2019. Between them, the two piers will have 24 adjacent aircraft parking positions. Pier H will have two levels for Schengen passengers and Pier J three floors for non-Schengen travelers.

The two gates are seamless shell structures. Several smaller sections were built about a meter apart and then joined by concrete. Seven sections would form the 400-meter-long Pier H, while the even longer Pier J measuring 600 meters, would comprise eight.

Read all Read more
April 2019

Cornerstone ceremony for the main terminal building

Work to build the main terminal building kicked off with a cornerstone ceremony on April 29, 2019. The building is the heart of Terminal 3 where many passengers begin and/or end their journeys. The spacious departure hall features an 18-meter-high ceiling and a surrounding glazed exterior. Travelers can conveniently check in here and drop off their luggage. And after clearing the security check, they can relax and enjoy themselves in a lounge area spanning 6,200 square meters plus a large marketplace filled with numerous shops, restaurants and cafés.

Read all Read more
May 2019

Start of construction of the drive-by table

Passenger cars and taxis will be able to use an access ramp to drive straight up to a drive-by platform measuring 550 by 30 meters in front of the departure hall. Another ramp leads back down on the other side.

But it will take a while before vehicles can roll over the asphalt. First the main load-bearing system of the 14.5-meter-high structure has to be built. A stable foundation for the drive-by table is ensured by 13-meter-long large bored piles and 28 transversely aligned reinforcing steel frames resting on V-shaped supports.

Read all Read more
July 2019

The new Sky Line train

Fraport is building a new Sky Line train to make sure that everyone can get to and from Terminal 3 without hassles, including passengers changing planes at Frankfurt Airport and those who come by rail to Terminal 1. Besides the tracks, a large maintenance building and a new station will be built at Terminal 1, with all of the work being done in tight conditions between other facilities without interrupting operations―a major engineering and logistical challenge!

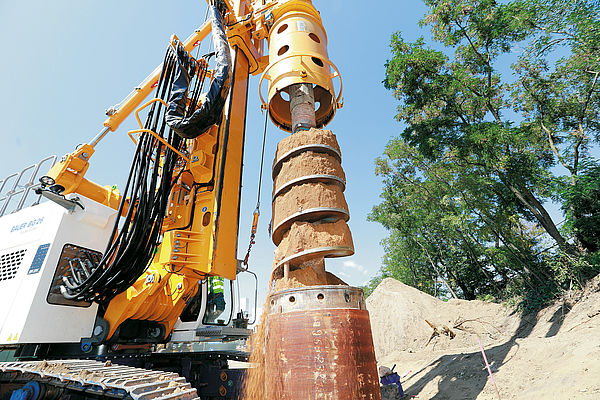

In addition to the preparatory work on the new Sky Line station at Terminal 1, the first bored pile work for the route was started in July 2019.

Read all Read more
Late 2019

Final steps of the foundation work

The foundation work at the Terminal 3 construction site neared its grand finale: concrete was poured into the last water-filled pit while work on the underground levels of the main building had already begun nearby. As soon as the underwater concrete was dry, the water was pumped out. After excavating 670,000 cubic meters of earth and pouring 40,000 cubic meters of underwater concrete, the foundation work was completed so that construction of the main terminal building could begin.

Read all Read more
March 2020

Start of work on the new maintenance building

To ensure regular service by the 12 trains of the new Sky Line line, work on a new maintenance building began east of Terminal 2. The preparations began in February 2020, followed by construction work that continued through the summer of 2021.

Read all Read more
April 2020

Construction of the parking facility

Construction of a new parking structure began next to Terminal 3. It would have room for 8,500 vehicle, with 2,200 parking spaces already available for use after the completion of Pier G.

Read all Read more
June 2020

Work progressing on the interior of Pier G

To make sure that passengers would also have a pleasant travel experience in Pier G, work on the larger installations, exterior walls, and interior systems got underway.

Read all Read more
4th quarter 2020

Main terminal building taking shape

After the cornerstone of Terminal 3 was ceremonially laid in April 2019, the main building rose steadily from the construction pits. The schedule called for the shells of all of the below-ground levels to be completed by the fall of 2020. While work continued on the upper levels, plumbing was already being installed down below. For the main building alone, this involved a total of about 290 kilometers of pipes for the HVAC, sanitary, and fire extinguishing systems: nearly the distance between Frankfurt and Munich as the crow flies.

Read all Read more
May 2021

A roof over the check-in hall

While work on the carcass of the main terminal building approached completion, the next milestone got underway: the roof of the check-in hall. This is roughly the size of two and a half soccer fields and therefore had to be shoved onto the top of the building from one side as a series of hinged elongated sections similar to those of a roller shutter (but much larger). First, however, the construction site was prepared for the heavy equipment required for this task. The auxiliary structures for connecting the sections were installed during the following summer. In the fall, heavy-duty cranes would go into action to lift the sections onto the roof and push them into their final positions.

Read all Read more
July 2021

The people mover station at Terminal 1

Work began to build the new Sky Line station between Terminal 1 and the Sheraton Hotel just a few minutes’ walk from the regional and long-distance train stations. The supports were installed, followed soon afterward by construction of the main body of the station and the connections between it, the terminals, the train stations, and the hotel. After arriving at the airport by train, passengers heading for Terminal 3 will proceed there.

Read all Read more
Summer 2021

Standing tall

The shell of the new apron control tower at Pier H reached its final height of nearly 70 meters. The shell of the turret, which extends six meters up above the tower’s shaft, had also already been completed. Beginning in the summer of 2021, this was followed by work to build the exterior and install various technical systems. Large angled glass panes will provide the controllers with a 300-degree view. The tower also boasts Terminal 3’s tallest elevator.

Read all Read more
October 2021

Heavy equipment helped the marketplace take shape

The impressive marketplace, featuring an exotic undulating steel ceiling 127.4 meters long, is the centerpiece of the main terminal building. Twenty steel girders had to be assembled to hold up the roof. Due to the marketplace’s location inside the main terminal building, it was necessary to use a special crawler crane. There were 45 truckloads of parts for the ceiling, which took three days to assemble. The crane carried the girders, weighing about 31 tonnes each, one at a time from the front of the building and lifted them into place.

Read all Read more
Late 2021

Construction of Pier G

The first phase of the work to build Pier G, which will have capacity for up to five million passengers a year, was largely completed before the end of 2021. Depending on how the demand situation develops as air travel volumes recover, Fraport AG has the option of putting it into operation earlier than the rest of Terminal 3. The main terminal building itself, including Piers H and J (for another 14 million passengers a year) presumably won’t be needed until 2026.

Read all Read more
1st quarter 2022

A bridge for the motorway interchange

A new bridge structure was installed to enlarge the Zeppelinheim interchange on the A5 motorway and optimally link the new Terminal 3 to the surrounding network of roads. First, piles were installed to support the 142-meter-long, four-section structure. In mid-2021, the bridge sections were then brought to the site and lifted into place at night while the entire motorway was temporarily blocked to traffic. The plans called for the interchange to begin operating in the first quarter of 2022.

Read all Read more
